Taking on a whole-house remodel is an exciting milestone. But the thought of moving out for six to twelve months? Not so much. Renting a temporary house in San Diego is incredibly expensive. Packing up your entire life is stressful. Because of this, many homeowners want to stay put.
The good news is that you absolutely can. By phasing the project carefully, you can stay in your home while it transforms around you. Here is exactly how to do it.
Yes, you really can. Let’s be honest right upfront, though. Living through construction is not a vacation. You will deal with loud noises, early mornings, and a fair amount of dust. It takes a certain level of patience.
However, the financial savings are massive. Skipping a long-term rental keeps thousands of dollars in your pocket—money you can redirect into luxury finishes for your home. With a strict phasing plan and a respectful design-build team, staying in your house is a smart, realistic choice.

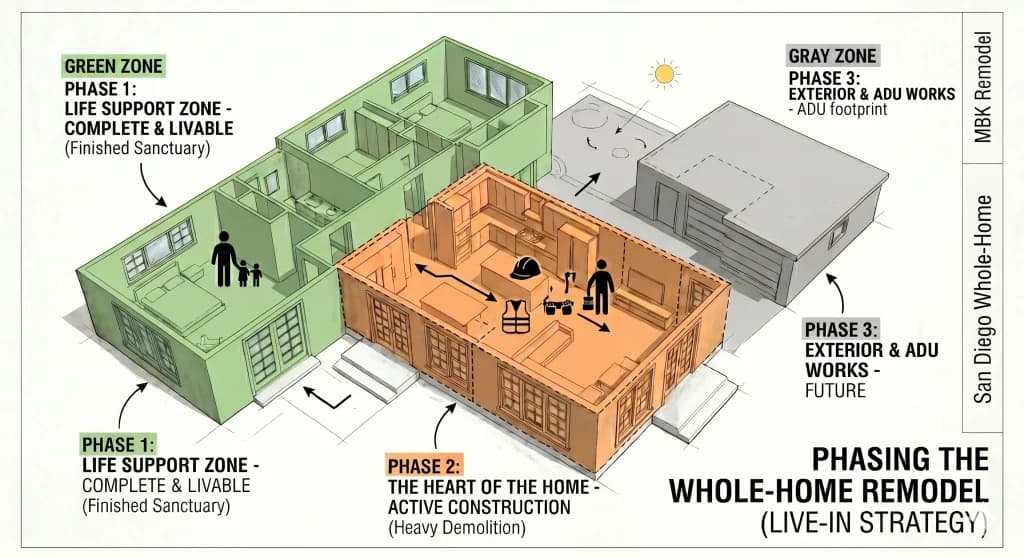

A successful live-in home remodeling project comes down to one simple concept: isolation. You cannot tear up the entire house at once. Instead, your contractor will divide your property into isolated construction zones. You simply move into the finished areas as the crew works on the rest.
First, we tackle the essentials. We call this the “Life Support” zone. Your contractor should remodel your secondary bedrooms and at least one full bathroom before touching anything else.

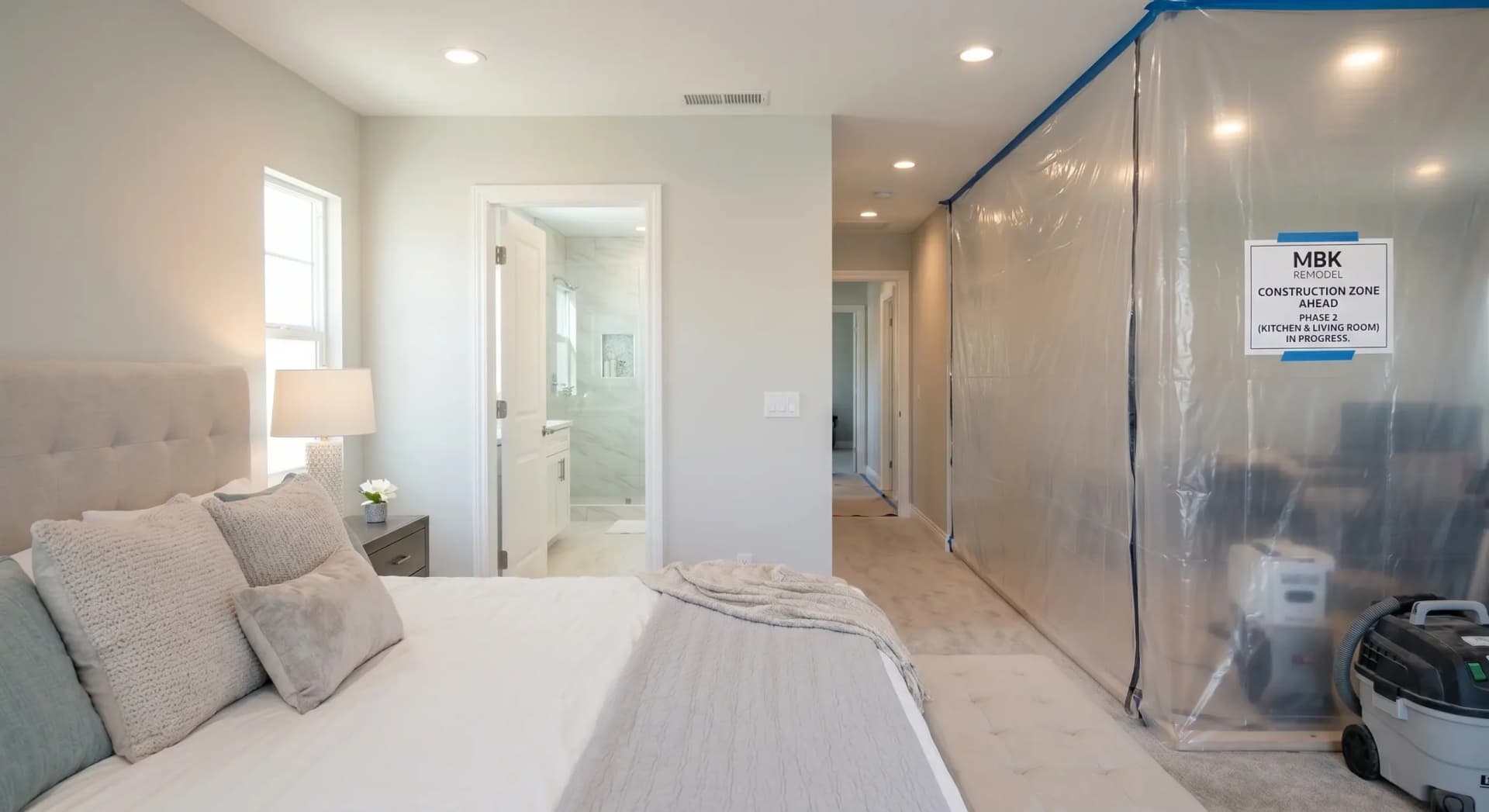

Once these rooms are complete, the team seals them off. This space becomes your family’s clean, quiet sanctuary. You now have a completely dust-free place to sleep, shower, and relax while the major work begins elsewhere.
Next, construction shifts to the main living areas. This includes your kitchen remodel, dining room, and family room. Prepare yourself, because this phase involves the heaviest demolition. Walls come down, framing changes, and old cabinets are torn out.
Fortunately, your family is already safely living in the completed Phase 1 zone. Because you have a designated living space, you stay separated from the daily chaos of the heavy construction zone.

Finally, the interior work wraps up. The crew moves outside to handle exterior siding, roofing, or building an Accessory Dwelling Unit (ADU). The best part of this final phase is that you have your house back. All the dirt, materials, and noise stay completely outside your doors.
Knowing the sequence is only half the battle. You also need a daily survival plan. Here is practical, actionable advice to help you maintain your sanity during the dusty months.
Losing your main kitchen is the hardest part of any remodel. To survive, you need to set up a temporary “micro-kitchen” in a spare bedroom or your garage.
Move your old refrigerator over before the crew tosses it. Set up a sturdy folding table for a microwave, a toaster oven, and your coffee maker. This simple, consolidated setup covers breakfast and quick dinners without the stress of eating out every night.
Living in Southern California gives you a massive advantage. We have incredible weather year-round. You should use it to your benefit.

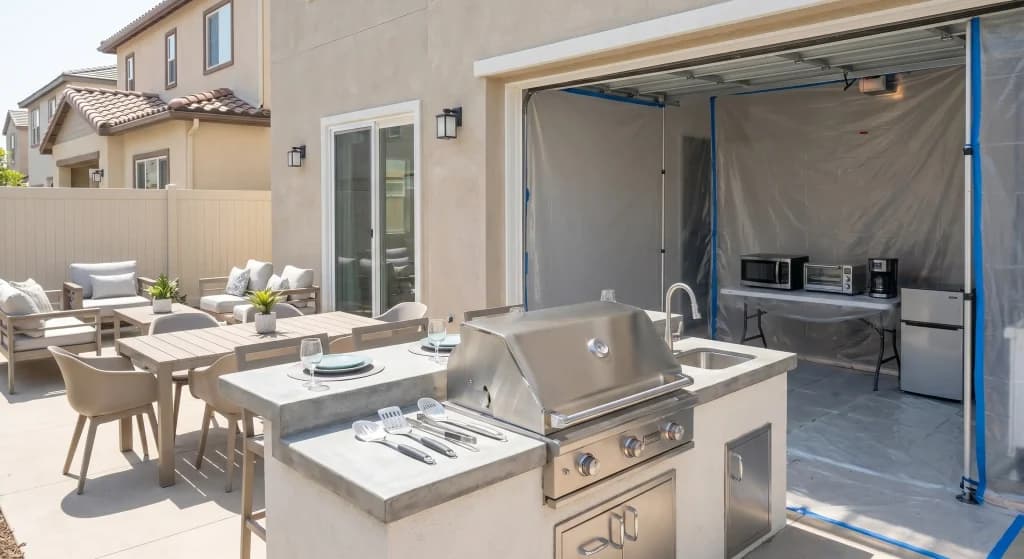

Move your dining table out to the patio. Fire up the backyard BBQ grill for evening meals. Create a comfortable outdoor lounge area where your family can hang out and escape the indoor mess. Leveraging your backyard makes a stressful process feel a little more like a staycation.

Safety is always the top priority, especially if you have kids or pets running around. Professional dust control is mandatory.
At MBK Remodel, we take this very seriously. We install heavy-duty zip-wall systems to physically seal off the active construction zones. We also use negative air pressure machines to pull dust straight out the window, keeping it out of your lungs. Finally, we lay down premium floor protection to keep your existing home completely safe from heavy work boots and dropped tools.
While phasing allows you to stay in your home, it does impact your project schedule. A standard whole-house remodel is usually demolished and built all at once. When you phase a project, construction happens in distinct segments.
This means the city inspection process changes. In San Diego, remodels require inspections at specific construction phases, including rough framing, electrical, plumbing, and drywall. Instead of the city inspector checking the entire house in one trip, they must inspect each isolated zone separately. Consequently, scheduling these multiple, segmented inspections can slightly extend your overall timeline.
Furthermore, simply securing the initial permit for a major remodel in San Diego can take anywhere from two to eight months, depending heavily on the scope of the structural changes. Navigating this bureaucracy requires serious expertise. At MBK Remodel, we manage the entire permit application process and coordinate all city inspections to prevent unnecessary delays and keep your phased project moving forward smoothly.
Living through a whole-home remodel requires a contractor who respects your space. At MBK Remodel, we specialize in occupied renovations. We understand that your house is not just a job site, it is where your family sleeps, eats, and lives.
We prioritize clear daily communication, so you always know exactly what is happening and when. Our strict dust control measures, organized project management, and strategic phasing ensure your daily routine is disrupted as little as possible. Are you ready to upgrade your San Diego home without the hassle of moving out?
Contact MBK Remodel today to discuss your phased renovation plan.
You can easily save tens of thousands of dollars. The average cost of a short-term rental or hotel in San Diego for six months is incredibly high. Staying in your home allows you to redirect that rental money straight into your renovation budget for better cabinets, flooring, or custom finishes.
Yes, it is safe, provided your contractor uses strict isolation protocols. By completely sealing off the active construction zones with zip-walls and negative air pressure systems, harmful dust and debris stay contained. However, you must designate a quiet, secure room far away from the work zone to protect your pets from heavy foot traffic and loud noises.
The core construction work for a standard remodel typically takes between two and six months in San Diego. However, when you deliberately phase the project so you can live on the property, you should expect to add a few additional weeks to the schedule. This extra time accommodates moving your living setup between zones and passing the necessary zone-by-zone city inspections.
